Create a Risk Matrix
To create a risk matrix:
- Navigate to RACE and select Risk Matrix.
-

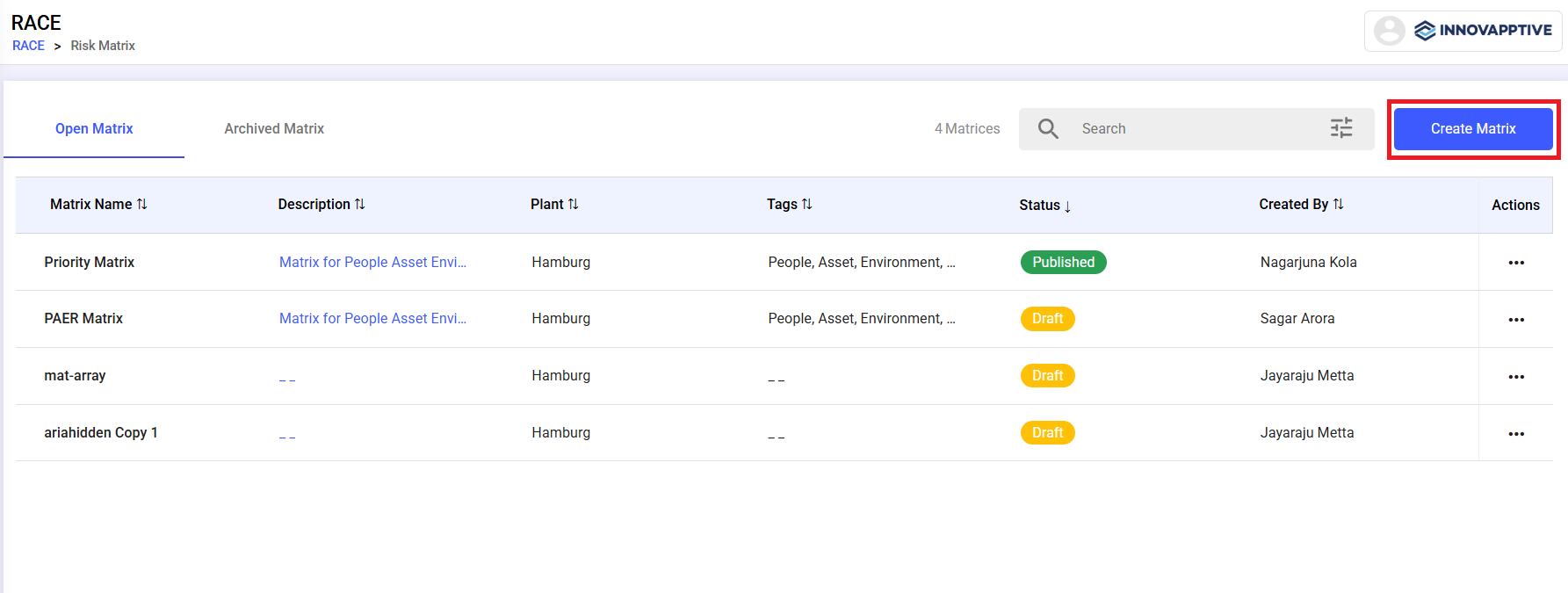

Click Create Matrix.
Figure 1. Create Risk Matrix
-

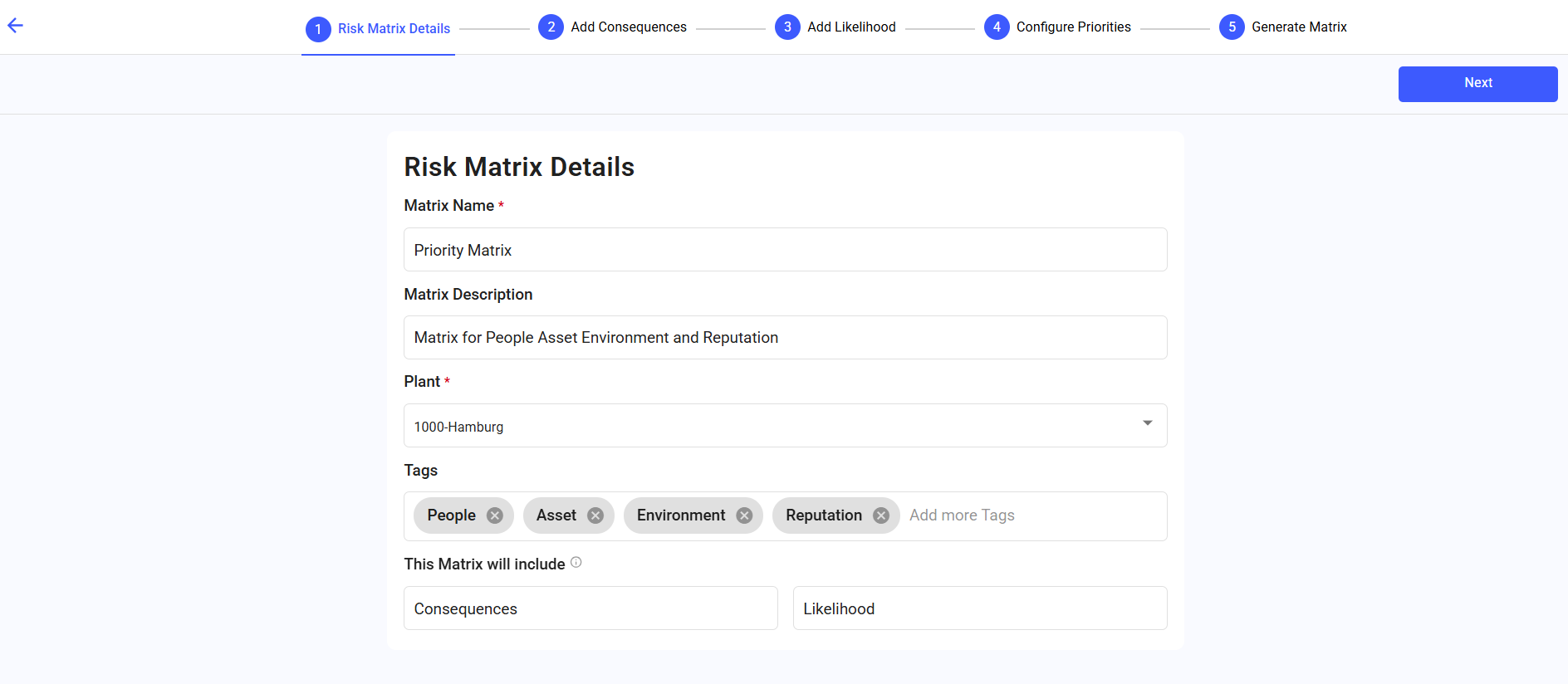

In the Risk Matrix Details screen, enter Matrix
Metadata:
- Matrix Name
- Matrix Description
- Plant
- Category (Issue or Work Order)
- Type
- Prioritization Profile
- Tags
- Define matrix components (e.g., Consequences, Likelihood)
- Click Next.
Figure 2. Risk Matrix Details
-

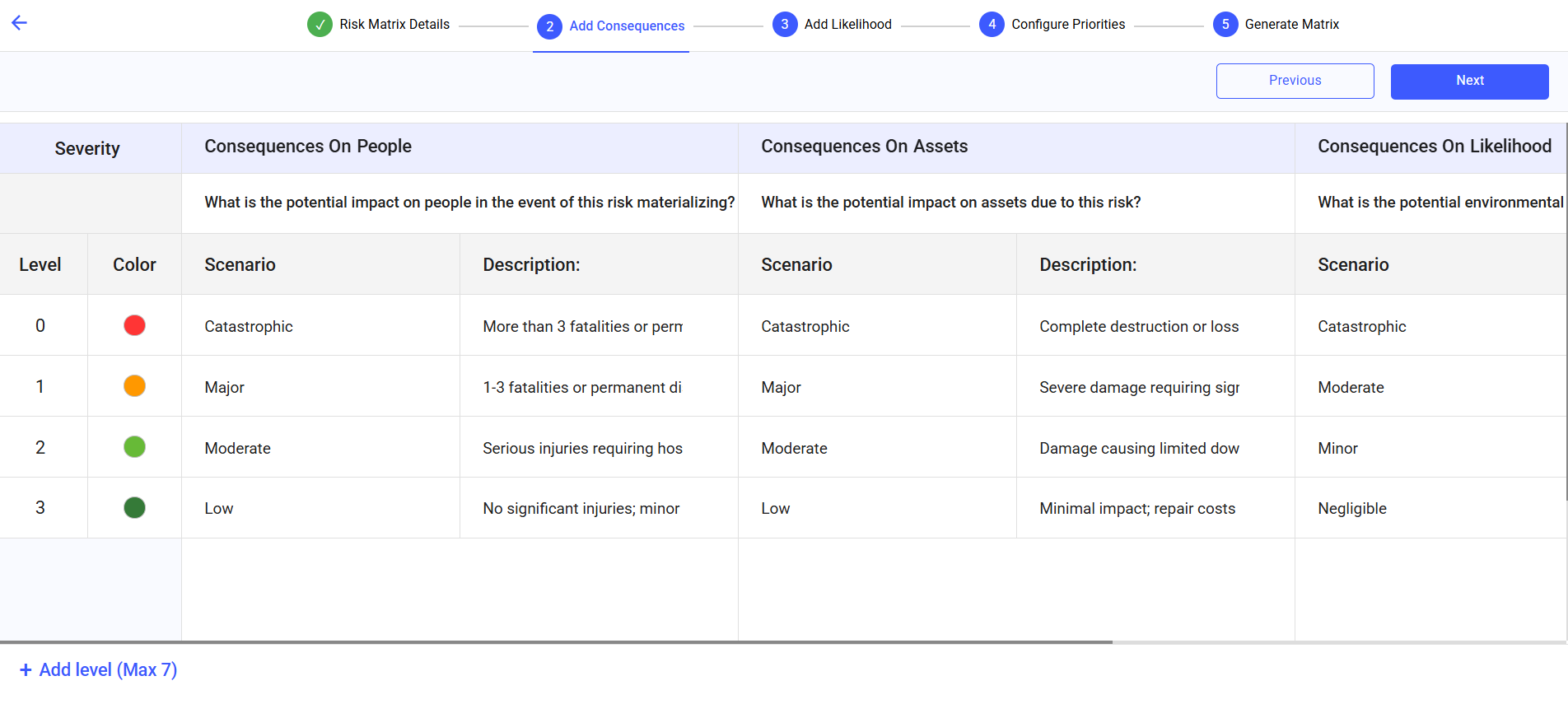

In the Add Consequences screen, add consequences,
- Click the + Add Consequences button at the right-side.
- Select the relevant color in the Color column.
- Define up to 5 consequence categories (e.g., People, Assets,
Environment).
- Add an evaluation question for each category.
- Define severity levels (0–5) with:
- A label
- A scenario
- A description
- You can add or remove levels as needed.
- Click Next.
Figure 3. Add Consequences
-

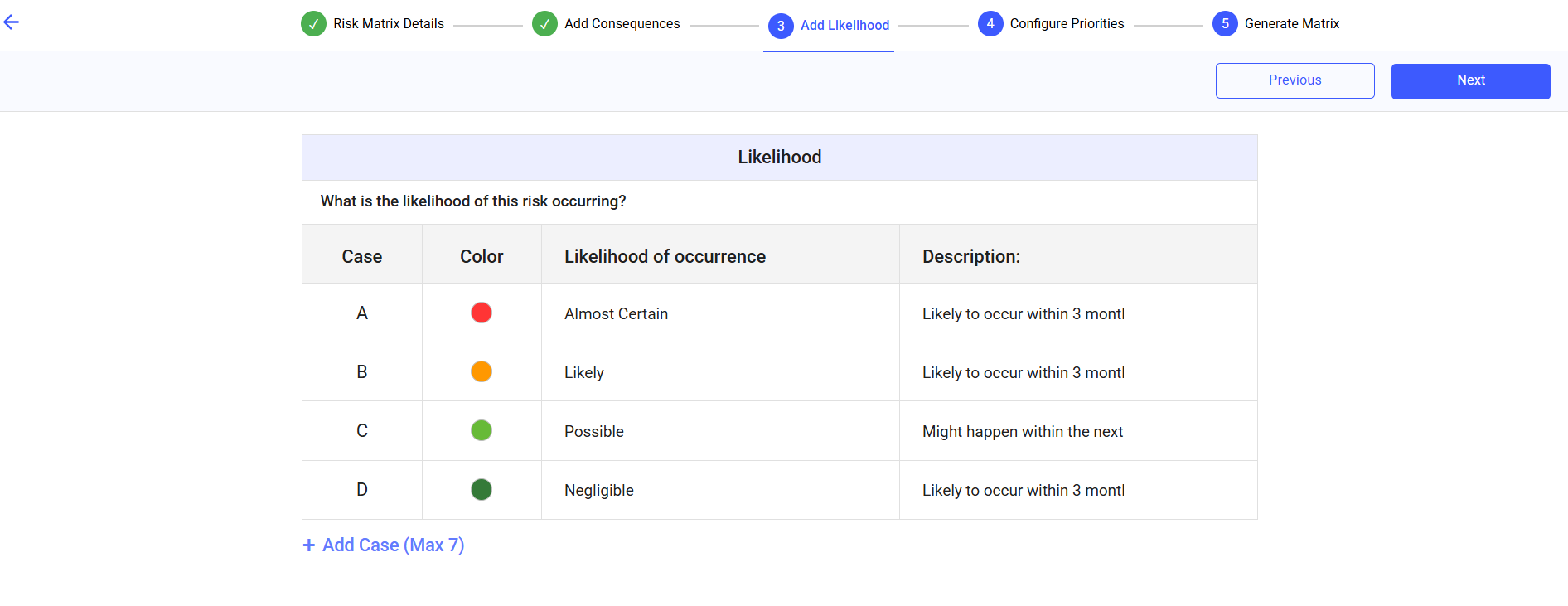

In the Add Likelihood screen, add Likelihood.
- Click + Add Case at the bottom.
- Select the relevant color in the Color column.
- Define scenario in the Likelihood of occurrence column.
- Add a description in the Description field.Note:You can add maximum 7 cases.
- Click Next.
Figure 4. Add Likelihood
-

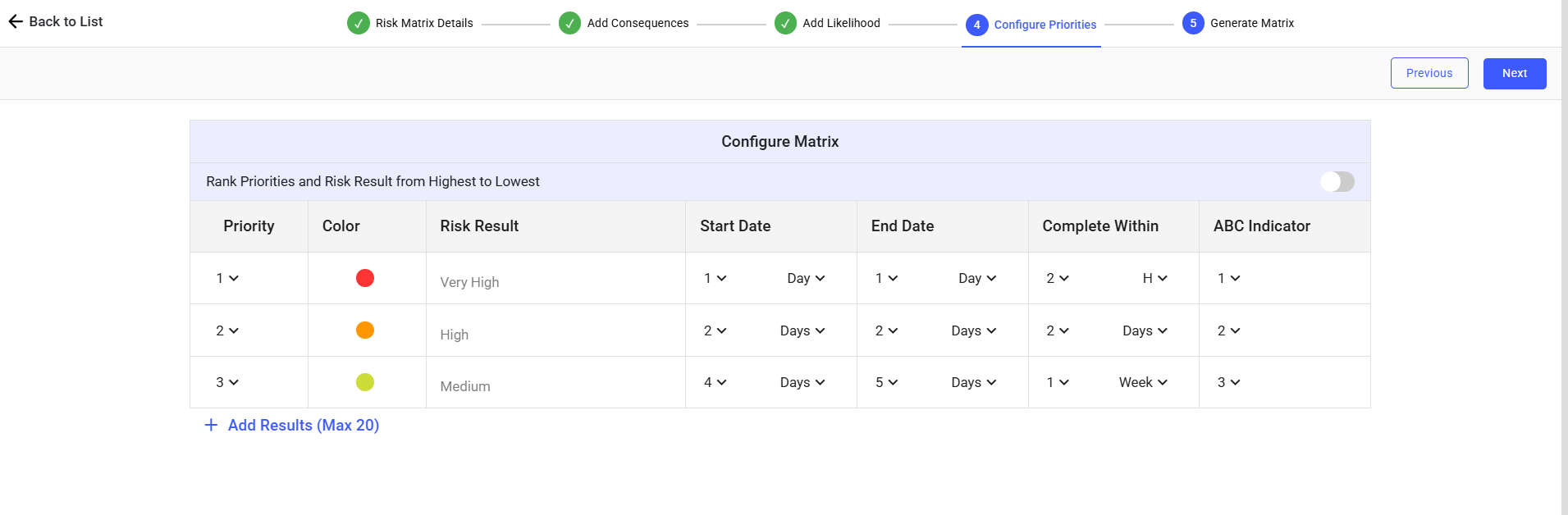

In the Configure Priorities screen, configure
Priorities.
- Click the + Add Results button at the bottom.
- Assign priorities (0, 1, 2…) based on consequence and likelihood
combinations:
- Name the risk results.
- Select start date and end date.
- Set response timeframes (e.g., 1 Day, 2 Weeks).
- Map risk level values to ABC indicators per plant, issue or work order (e.g., High risk level can be mapped to both A and B classes.
- Rank results from highest to lowest if needed.
- Click Next.
Figure 5. Configure Priorities
-

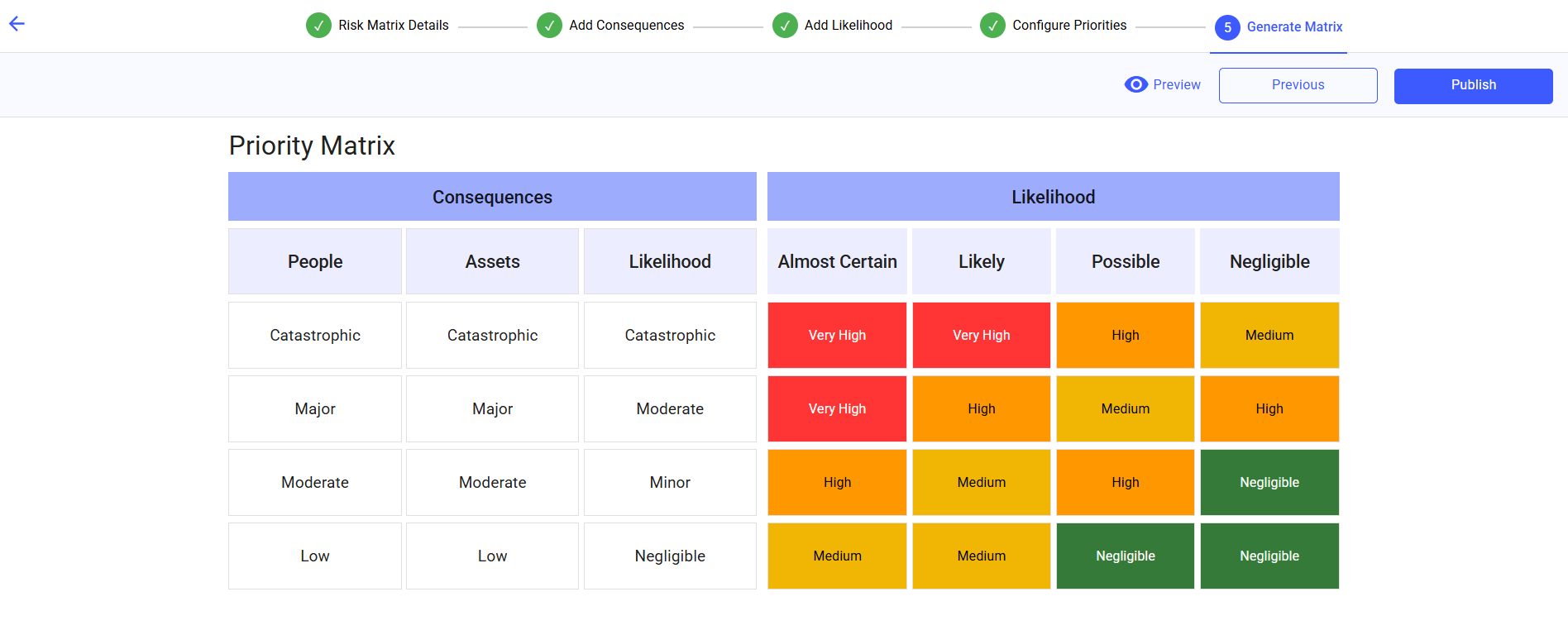

In the Generate Matrix screen, generate the
matrix:
- Review the color-coded matrix.
- Each cell represents a risk level (e.g., Very High, Medium).
- Click on the cell to change the risk level.

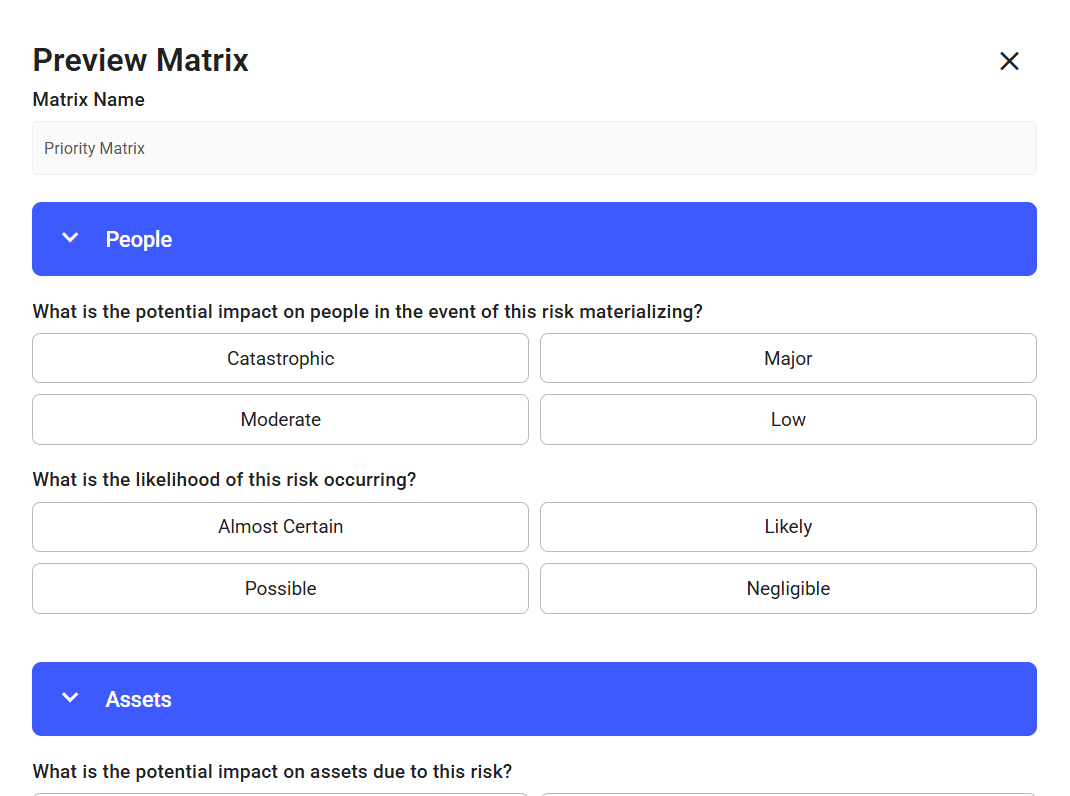

- Click Preview to view risk matrix in its final
form.
Figure 6. Matrix Preview
- Click Publish.
Figure 7. Generate Matrix
The matrix is now available for use in incident reporting or form configurations.
Use More icon to Edit, Copy, Preview, or Archive a matrix.
